Reports

The Reports page allows you to run Monte Carlo reports of the tasks in the project, such as:  Cumulative Curves, Tornado and Status.  The reports are run based on the scenario applied for the project.

Monte Carlo Charts:

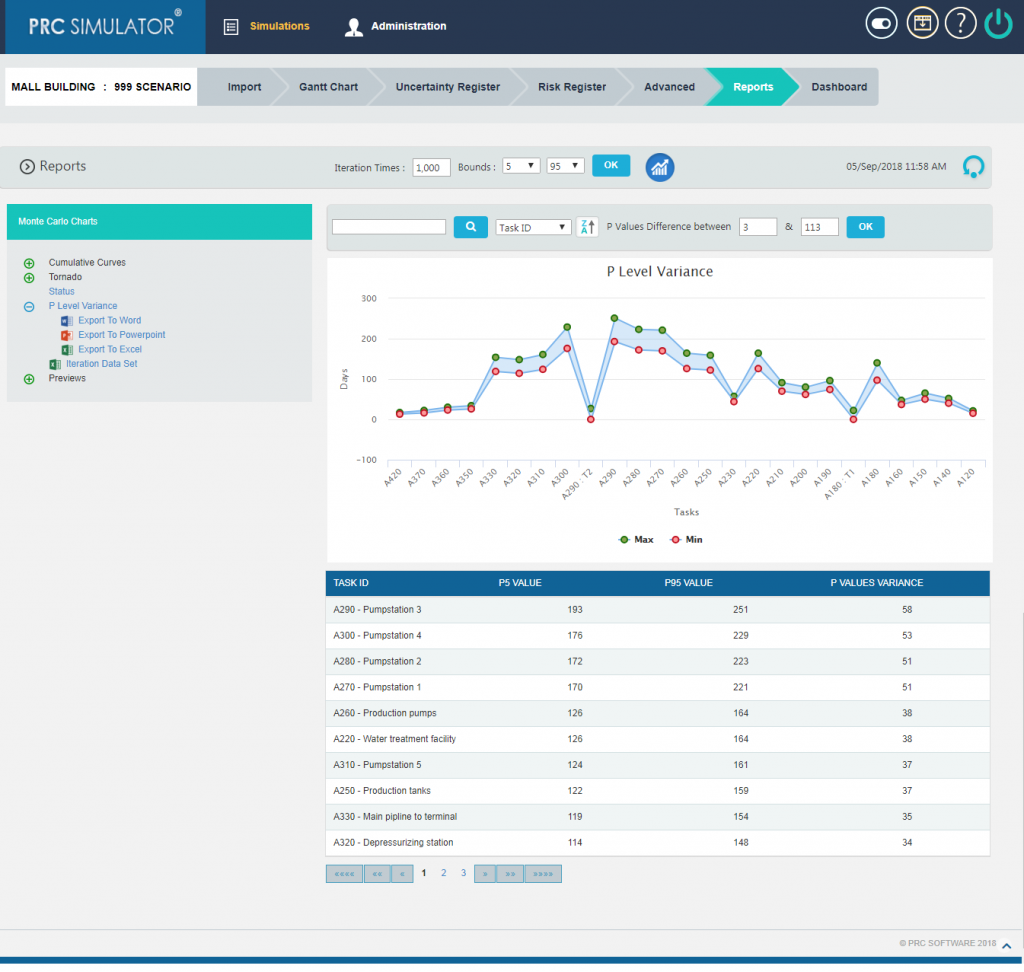

sim_reports

Figure 1

Cumulative Curves:

The Cumulative Curves report includes Duration: Duration with Risk Events, Duration without Risk Events, Delta of Cumulatives (Duration); Start Date: Start Date with Risk Events, Start Date without Risk Events, Delta of Cumulatives (Start Date); Finish Date: Finish Date with Risk Events, Finish Date without Risk Events, Delta of Cumulatives (Finish Date).  The Cumulative Curve report shows the distribution of the estimated duration exposure of a selected project or task.  It simulates duration values based on distribution types.  The columns show the hits for each of the total amount of task simulation duration exposure.

The steps that are carried out to generate Cumulative Curves chart are follows:

  • Generate risk groups for the given correlations. Grouping is done such that all the tasks that are correlated with one another are considered as a group.
  • Generate correlated random values for each risk group.  The static calculation is explained below:
  1. Create a correlation matrix with correlation coefficients such that task which is more correlated comes in the first row.

correlation matrix is used to investigate the dependence between multiple variables at the same   time. The result is a table containing the correlation coefficients between each variable and the others.

  1. Calculate unspecified coefficients in the matrix from correlation of two related specified correlation coefficients.

b.1: Find Eigen values and Eigen vectors matrices of the inconsistent correlation matrix.

b.2: Replace the non-positive Eigen values with the smallest positive double number.

b.3: Create a Diagonal Matrix of Sqrt (1 / (Eigen Vectors^2 * Eigen Values))

b.4: Create a Diagonal Matrix of Sqrt (Eigen Values)

b.5: Multiply the diagonal matrix in step 3 with Eigen vectors matrix which is multiplied the matrix in step 4.

  i.e., Diagonal Matrix of Sqrt (1 / (Eigen Vector^2 * Eigen Values)) * Eigen Vector *     Diagonal Matrix of Sqrt (Eigen Values)

b.6: Multiply the matrix got from step 5 with its transpose. Now we will get the correlation matrix which is consistent.

b.7: Replacing the inconsistent coefficients with coefficients calculated from consistent coefficients. r  = (6 * asin(Correlation Coefficient / 2) / p) * 100

  1. Perform cholesky decomposition of the correlation matrix (CHOL). If exception occurs, then the correlation matrix is inconsistent.  Then the simulation is stopped and asks the user whether to adjust correlations of the risk group automatically or not.  If no exception occurs, then perform the remaining steps.

The Cholesky decomposition or Cholesky factorization is a decomposition of a Hermitian, positive-definite matrix into the product of a lower triangular matrix and its conjugate transpose, which is useful example for efficient numerical solutions and Monte Carlo simulations.

  1. Create a matrix (R) with number of rows is equal to iteration times and number of columns equal to number of tasks in the risk group with randomly generated values which are normally distributed with mean 0 and SD 1.
  2. Multiply the matrix generated in (d) with matrix generated by cholesky decomposition. This gives the normally distributed random values with correlation (these values used in normally distributed durations).  To get it uniformly distributed, find the cumulative distribution function of the matrix (these values are used for other distributions).  Each columns will have the random values for corresponding task durations.

I.e., correlated random value matrix CRM is

CRM = R * CHOL, if normal distribution

CRM = pnorm(R * CHOL), if not normal distribution

The cumulative distribution function (CDF) of a real-valued random variable X, or just distribution function of X, evaluated at x, is the probability that X will take a value less than or equal to x.

Example

An example for normal distribution with 10 iterations is given below.

  1. a) Let A, B, C, D are correlated such that corr (A, B) = 60%, corr (A, C) = 70%, corr (A, D) = 80%. Now we have one risk group ABCD.
  2. b) Correlation Matrix with user specified correlation coefficients
  1.0 0.6 0.7 0.8
0.6 1.0 0.0 0.0
0.7 0.0 1.0 0.0
0.8 0.0 0.0 1.0

  1. c) Correlation Matrix after calculating all correlation coefficients
1.0 0.5112 0.5936 0.6748
0.5112 1.0 0.0302 0.0343
0.5936 0.0302 1.0 0.0398
0.6748 0.0343 0.0398 1.0

  1. d) Matrix with random values, R
-0.22759883330513203 -0.14779528819416274 -0.8116534929634235 -1.3828258408574279
-0.6257058657442784 0.22979287727014666 0.6940068141614696 -1.2819970948797965
0.9606080643281025 -0.4206689845495361 0.39631036444761714 1.8294529311210064
-1.0168529345485386 -0.269590041200955 1.1562633168199357 0.0783761626803479
-0.672674228450859 1.44034555165658 -0.917837438474965 -0.6932982668435381
0.8837124607600431 -0.2701592828005509 -0.17588784441744762 -1.8498741062127289
-2.080382126627115 -0.41529290972909144 0.2850056186845682 -0.6517288518888447
-0.9457988314984864 0.3727895888956935 0.506852288539806 1.036366371238769
-0.6255515357453936 1.7962144206953343 0.7777261622008658 -0.7355621784937361
-0.0612578037946805 -0.3693649019492818 -1.6725197303227222 -0.6444577847858889
  1. e) Matrix with correlated random values
Task A Task B Task C Task D
-0.22759883330513203 -0.14779528819416274 -0.8116534929634235 -1.3828258408574279
-0.6257058657442784 0.22979287727014666 0.6940068141614696 -1.2819970948797965
0.9606080643281025 0.12951392609894774 0.9969510606030434 0.5490356353852022
-1.0168529345485386 -0.7515175581895532 0.33692856764956125 -1.3325301102147291
-0.672674228450859 0.8940508933639131 -1.5357821937125395 -0.38541097828943366
0.8837124607600431 0.21956223049086745 0.4804300141584299 0.8033496303121265
-2.080382126627115 -1.4204197286554967 -0.8921771773333548 -1.4384490197892787
-0.9457988314984864 -0.16309395713329183 -0.30523272399453705 -1.0969624106348446
-0.6255515357453936 1.2239957073107248 -0.36742658070420897 -1.5732911013915596
-0.0612578037946805 -0.34877000727229757 -1.1554191662901698 1.1669823548362461

Each column in the matrix contains the random values for corresponding tasks for each iteration.

  • Generate random values for resources of those tasks which are not correlated.
  • Generate random values for resource rates of those tasks which are not correlated.
  • Set the random values of resources as random values for resource rates of those tasks which are correlated.
  • For each resource of a task generate values based on the distribution and number of iterations with given uncertainties. For import type “Multiple Resources”, there can be multiple resources for a task and the uncertainties may be different for each of them.
  • Generate values based on the distribution and number of iterations with given uncertainties for corresponding resource rate of each resource. For import type “Simple Uncertainty”, the values will be same for all iteration.
  • For each iteration, multiply the values of resource and resource rate respectively to find the duration for each resource.
  • For each iteration, add the duration of all resources.

Duration with Risk Events:

The Duration report shows the distribution of the estimated duration exposure of a selected project or task.  It simulates duration values based on distribution types.  The columns show the hits for each of the total amount of task simulation duration exposure.  The curve shows the cumulative frequency of the hits in percentage.  To get individual task’s Cumulative Curve report, select the task from the PROJECT REPORT dropdown.

Steps:

  1. Simulations —>Reports
  2. Click Duration with Risk Events link under Cumulative Curves. (Figure 1)
  3. Select the Bar width and set the Iteration Times and then click RUN ANALYSIS (Figure 2)  The chart generated and the table is shown in the Figure 2

sim_reports_duration_with_risk_events

Figure 2

Duration without Risks Events:

The Duration report shows the distribution of the estimated duration exposure of a selected project or task without considering the risks associated with it.  It simulates duration values based on distribution types.  The columns show the hits for each of the total amount of task simulation duration exposure.  The curve shows the cumulative frequency of the hits in percentage.

Steps:

  1. Simulations—>Reports
  2. Click Duration without Risk Events link under Cumulative Curves. (Figure 1)
  3. Select the Bar width and set the Iteration Times and then click RUN ANALYSIS (Figure 3)  The chart generated and the table is shown in the Figure 3

sim_reports_duration_without_risk_events

Figure 3

 Delta of Cumulatives:

The Delta of Cumulative chart shows the variation Curve of durations with risk and without risk.

Steps:

  1. Simulations—>Reports
  2. Click Delta of Cumulatives link under Cumulative Curves. (Figure 1)
  3. Set the Iteration Times and then click RUN ANALYSIS (Figure 4)  The chart generated and the table is shown in the Figure 4

sim_reports_duration_delta

Figure 4

 Start Date with Risk Events:

Steps:

  1. Simulations —>Reports
  2. Click Start Date with Risk Events link under Cumulative Curves. (Figure 1)
  3. Select the Bar width and set the Iteration Times and then click RUN ANALYSIS (Figure 5)  The chart generated and the table is shown in the Figure 5

sim_reports_start_date_with_risk_events

Figure 5

Start Date without Risk Events:

Steps:

  1. Simulations—>Reports
  2. Click Start Date without Risk Events link under Cumulative Curves. (Figure 1)
  3. Select the Bar width and set the Iteration Times and then click RUN ANALYSIS (Figure 6)  The chart generated and the table is shown in the Figure 6

sim_reports_start_date_without_risk_events

Figure 6

 Delta of Cumulatives (Start Date):

The Delta of Cumulative chart shows the variation Curve of durations with risk and without risk.

Steps:

  1. Simulations—>Reports
  2. Click Delta of Cumulatives (Start Date) link under Cumulative Curves. (Figure 1)
  3. Set the Iteration Times and then click RUN ANALYSIS (Figure 7)  The chart generated and the table is shown in the Figure 7

sim_reports_start_date_delta

Figure 7

 Finish Date with Risk Events:

Steps:

  1. Simulations —>Reports
  2. Click Finish Date with Risk Events link under Cumulative Curves. (Figure 1)
  3. Select the Bar width and set the Iteration Times and then click RUN ANALYSIS (Figure 8)  The chart generated and the table is shown in the Figure 8

sim_reports_finish_date_with_risk_events

Figure 8

 Finish Date without Risk Events:

Steps:

  1. Simulations—>Reports
  2. Click Finish Date without Risk Events link under Cumulative Curves. (Figure 1)
  3. Select the Bar width and set the Iteration Times and then click RUN ANALYSIS (Figure 9)  The chart generated and the table is shown in the Figure 9

sim_reports_finish_date_without_risk_events

Figure 9

Delta of Cumulatives (Finish Date):

The Delta of Cumulative chart shows the variation Curve of durations with risk and without risk.

Steps:

  1. Simulations—>Reports
  2. Click Delta of Cumulatives (Finish Date) link under Cumulative Curves. (Figure 1)
  3. Set the Iteration Times and then click RUN ANALYSIS (Figure 10)  The chart generated and the table is shown in the Figure 10

sim_reports_finish_date_delta

Figure 10

Tornado Charts:

The Duration Values with Risk Events Isolated To P, Duration Percentages with Risk Events Isolated To P, Duration Values without Risk Events Isolated To P, Duration Percentages without Risk Events Isolated To P and Correlation Isolated to P reports are Tornado Charts that depends on the simulated duration exposure values of each task up to the Pn iteration value, where ‘n’ is the percentile value of total number of iterations given.  The x axis represents the duration exposure and the y axis represents the task names.

Duration Values with Risk Events Isolated To P:

sim_reports_duration_values_with_risk_events_isolated_to_p

Figure 11

Duration Percentages with Risk Events Isolated To P:

sim_reports_duration_percentages_with_risk_events_isolated_to_p

Figure 12

Duration Values without Risk Events Isolated To P:

sim_reports_duration_values_without_risk_events_isolated_to_p

Figure 13

Duration Percentages without Risk Events Isolated To P:

sim_reports_duration_percentages_without_risk_events_isolated_to_P

 Figure 14

Correlation Isolated to P:

The step to generate the Correlation Isolated to P (n) chart is:

Pearson correlation coefficient for Total duration up to p(n) and Task duration up to p(n) * 100

sim_reports_correlation_isolated_to_p

Figure 15

Status charts:

This Monte Carlo chart is a pie chart which shows the total number of tasks included in the project.  And the number of risks mapped to the tasks as threat and opportunities are also counted.

Steps:

  1. Simulations —> Reports
  2. Click Status link under Monte Carlo Charts.  (Figure 2)  The chart generated and the table is shown in the Figure 16

sim_reports_status

Figure 16

Iteration Data Set:

This functionality is used to export the tasks with risk events and without risk events along with Task Id, Task Name and Planned Duration of the selected project to MS Excel.  A sample spreadsheet is shown in Figure 17.  Iterations value are calculated for each task separately based on the number of iteration specified.

sim_reports_iteration

Figure 17

2.8.1 Export to Word:

This functionality is used to export the Simulation Monte Carlo reports and data table as a Word document.

Steps:

  1. Simulations —> Reports
  2. Click the Export to Word link.  (Figure 2)

2.8.2 Export to PowerPoint:

This functionality is used to export the Simulation Monte Carlo reports generated to PowerPoint.

Steps:

  1. Simulations —> Reports
  2. Click the Export to PowerPoint link.  (Figure 2)

2.8.3 Export to Excel:

This functionality is used to export the Simulation Monte Carlo reports as an excel file.

Steps:

  1. Simulations —> Reports
  2. Click the Export to Excel link.  (Figure 2)
